ERP Modernization 2025 Trends: Data, Deadlines & AI

Noel DCosta

ERP modernization in 2025 is no longer just a technical upgrade. It’s a structural shift away from legacy ERP systems like SAP ECC and Oracle EBS toward modular, cloud-based platforms such as S/4HANA and Oracle Fusion.

So, you might ask, what is the real story? ERP is no longer expected to do everything. Most enterprise teams have realized that trying to cram every workflow, ticket, or approval into the core ERP slows them down. This is where platforms like ServiceNow, Salesforce, and Workday come in, not to replace ERP, but to handle what ERP shouldn’t.

At the center of this shift is the clean core approach, especially for SAP customers. Instead of heavy customizations, companies are aiming for:

  • Cloud-first ERP deployments

  • Strict separation of extensions and the core

  • Leaner upgrade paths

  • API-first integrations across systems

S/4HANA’s clean core model is not just about “keeping it clean”, it’s about avoiding the mess that made previous migrations painful. I’ve broken down those trade-offs in detail in this migration guide.

There’s also no pretending that ERP sits alone anymore. As cloud adoption climbs (Gartner pegs ERP cloud penetration at 60% in 2025), hybrid ERP ecosystems are becoming the default. Some parts live on-premise, some in SaaS, and the governance model has to stretch to cover both.

Hybrid ERP adoption is growing at 13% CAGR (2023–2026), and that growth reflects more than budget, it reflects a change in mindset.

And honestly, that mindset shift might be the hardest part.

ERP Modernization in 2025

ERP Modernization in 2025 moves from planning to execution because ECC and EBS timelines are closing in, clean core is mandatory, and quarterly releases require disciplined testing. Meanwhile, budgets move to cloud OPEX and a backbone plus satellites architecture, where ServiceNow and Salesforce carry workflows and where governance, integration, and audit evidence drive most of TCO.

10 Key Takeaways on ERP Modernization Trends for 2025

  1. So ERP Modernization in 2025 starts with a clean core and steady scope, and I still sketch the standard process first before any extensions. And I point leaders to a practical S4HANA migration path when old ECC habits creep back in.
  2. Next, AI value shows up only when testing keeps pace, and I have watched releases stall because validation was manual. And this side-by-side view of testing and validation tools helps right-size automation early.
  3. Also, quarterly updates turn governance into muscle memory, and finance cares because breaks now hit the close. And teams I coach align controls with this primer on AI compliance in SAP programs.
  4. Moreover, cloud spend gets real once you model OPEX month by month, and I like to provoke a budget debate using this ERP cost calculator. And that simple exercise usually pulls hidden TCO into the light.
  5. Meanwhile, SAP ECC deadlines push choices faster than comfort allows, and leaders ask if a brownfield can carry all the way. And I reply that momentum improves when the migration plan is traced back to the ECC to S4HANA checklist.
  6. In addition, CRM and workflow rarely live inside core ERP now, and the spine must welcome neighbors. And the pitfalls show up clearly in this note on Salesforce integration failures and fixes.
  7. Furthermore, the integration fabric needs its own roadmap, and I treat it like a product with owners and SLAs. And this overview of SAP integration platforms helps frame that decision.
  8. Likewise, capacity wins projects more than slideware, and I still map skills to work packets with sticky notes first. And hiring goes smoother when roles mirror the guide on essential implementation team roles.
  9. Additionally, data migration remains the long pole every single time, and I suggest an early sizing pass with the free migration estimator. And that quick run often resets timelines to something believable.
  10. Finally, change only sticks when sponsors back it in rooms that matter, and I have seen dull steering meetings save quarters. And the governance rhythm lands best when chairs follow this playbook for a strong project steering committee.

What ERP Modernization in 2025 Means to Businesses Globally

ERP Modernization in 2025

I believe that ERP modernization in 2025 has reached an inflection point. This is no longer about roadmaps or workshops. It’s execution time.

In 2024, leaders were still buying time, spending quarters analyzing SAP ECC deprecation timelines and debating hybrid vs. full-stack migrations. By mid-2025, that delay is catching up. The technical debt from ECC is now operational debt.

Regulatory risk is creeping in, especially in industries like pharma, aerospace, and public sector, where traceability and documentation must be auditable in real-time. Running an SAP ECC 6.0 solution or an Oracle e-Business Suite solution is no longer practical

1. Deadlines are now forcing decisions

  • SAP’s ECC support cliff is now visible. 2033 is no longer “later.” Companies waiting for “later”, will struggle to find resources to migrate to the latest versions, when they need them. Every implementation comes with its own problems and hence, planning the implementation early is always a better option.

  • Only 35% of SAP ECC customers have begun their S/4HANA migrations as of mid-2025. Of those, many are still stuck in sandbox purgatory. Some of my own clients are still debating on the best way forward. They know what the outcome should be, but they don’t know how!

  • Oracle Fusion adoption is also lagging. While 40% of Oracle EBS customers are exploring Fusion Cloud, fewer than 1 in 5 are live. The biggest problem Oracle customers face is tailoring the solution to meet their regulatory requirements. Oracle is a good system, but it also needs simplicity and structure in processes.

As you can see, these delays are not just technical. They’re cultural. Clean core adoption, for example, is not a technical constraint. It’s a discipline problem. The resistance often comes from business leads who still expect custom code to “just be re-implemented.” It’s not 2012 anymore. That model breaks your quarterly cadence and leads to failed regression tests post-upgrade.

See: SAP Clean Core Strategy – What It Means for Your Business

2. Cloud ERP is shifting budgets, not just infrastructure

The numbers are striking. Public cloud spend is set to hit $679B in 2025 (IDC). But what’s more important is how spend is shifting, from CAPEX-heavy licensing and infrastructure builds to OPEX-dominated subscription and platform models.

However, CFOs aren’t thrilled about it. While cloud delivers agility, many teams underestimated the operational overhead from service integration, monitoring, and licensing sprawl.

Practical implications:

  • Cloud billing is less predictable across modules, especially with usage-based pricing.

  • Many companies now need cost governance tooling (e.g., FinOps for ERP) just to manage ERP spend.

  • Vendor lock-in is resurfacing. Just with prettier UX.

3. Finance and supply chain are impacted in different ways

Finance teams are grappling with AI. Not the concept, but the audit trail. AI now runs parts of Accounts Payable, Accounts Receivable, and Risk Classification. Yet most internal audit teams are still using Excel templates last updated in 2019. This creates issues during compliance audits.

See: Case Study: Finance Process Modernization

Supply chains face a different issue. Partial modernization. For example:

  • SAP IBP runs planning. But execution is still in SAP ECC LE-WM or even spreadsheets.

  • Procurement moved to SAP Ariba, but GRN is manual.

  • Transport planning runs in SAP Transportation Management, but updates take 12 hours to reflect in inventory.

So you can expect Bottlenecks. Not from technology, but fragmentation. You can see a real-world breakdown of this fragmentation in my analytics cloud recovery piece.

4. ERP is no longer the only platform that matters

You now have solutions like ServiceNow handling process orchestration, Salesforce driving customer workflows, and Workday owning HR lifecycle. ERP has become the financial backbone, not the end-to-end process hub it once was.

Enterprise architects in 2025 are revising the traditional blueprint. Instead of forcing everything back into SAP or Oracle, they’re building interoperability. Think event-driven APIs, context-aware automation, and layered governance across tools.

More here: ERP Modernization with ServiceNow

Cloud-based share of ERP deployments (% of new and major upgrades)

Sources and method

  • Source for the 2025 cloud share is based on Gartner’s data. 60% of ERP deployments are cloud based by 2025.

  • Source for the hybrid ERP growth anchor equals Gartner. Hybrid ERP adoption grows at a 13% CAGR from 2023 to 2026.

  • Method for cloud series equals straight line interpolation around the 2025 anchor. 6% points included per year to keep the slope practical for planning.

  • Method for hybrid series equals CAGR math. 2023 to 100. Applied 13% compounded yearly through 2026. Extended the same rate to 2027 and 2028 as a projection so your chart has a complete horizon.

Important Statistics to Consider

ERP Modernization in 2025 — Key Stats

ERP Modernization in 2025

Key Stats You Should Know

Platforms Cloud spend Adoption AI usage Governance

70%

of enterprises run ServiceNow alongside ERP.

55%

integrate Salesforce CRM into modernization roadmaps.

30%

system integrator demand exceeds supply for S/4HANA projects.

25%

more firms piloted S/4 in 2025 compared with 2024.

$679B

public cloud spend in 2025. IDC.

60%

of ERP deployments are cloud based by 2025. Gartner.

13% CAGR

for hybrid ERP adoption from 2023 to 2026.

35%

of ECC customers started S/4 migrations by mid 2025.

40% / <20%

of Oracle EBS customers are exploring Fusion, while fewer than one in five are live.

72%

of CFOs expect AI anomaly detection in finance by 2026.

65% / 30%

of supply chain leaders use AI for planning in pilots and in production respectively.

12–15%

budget increase linked to AI readiness in ERP programs.

70%

use ServiceNow for IT and HR workflows alongside ERP.

15–20%

of ERP modernization budgets go to governance and integration.

Notes. Percentages reflect program level observations and cited analyst figures where indicated. IDC for public cloud spend in 2025 and Gartner for cloud ERP share.

The New ERP Role in 2025: Modernization focussed on Simplicity

ERP Modernization in 2025

ERP modernization in 2025 is less about replatforming and more about reshaping how ERP fits into the business. It really cannot be a technical discussion alone, business has to get involved. It’s a shift that many executives still underestimate.

You do not need another monolith implementation. What you need is clarity on scope, ownership, and how your ERP work seamlessly with everything else. This is extremely important.

For years, the assumption was that ERP had to do it all. Financials, logistics, HR, analytics, procurement, CRM, EHS and the list goes on. I know that SAP or Oracle folks will not agree with me on this, but this is the reality. Running one ERP is no longer sustainable.

The effort to stuff everything into one system is not just unnecessary, it’s harmful. It adds friction, raises costs, and confuses ownership. You are forcing the ERP to work in a way that it was not built for. Now, ERP should return to its roots: stable, transactional, and clean.

1. Core Systems vs. Ecosystem Players

Today’s architecture separates the backbone from the brain. SAP S/4HANA or Oracle Fusion serve as transactional hubs. But the intelligence often lives elsewhere.

  • Workday or SuccessFactors handles workforce management

  • Salesforce or SAP CRM covers customer engagement

  • ServiceNow owns operational workflows

  • Analytics tools such as SAP Analytics Cloud, Power BI, Snowflake, do the heavy lifting on insights

This layered approach means decisions must be intentional. For those navigating the chaos of hybrid ERP, I laid out a few real project challenges in this article on ERP modernization mistakes.

2. The Importance of a Clean Core Strategy

Clean core is not a buzzword anymore. It’s a requirement if you want ERP systems that can survive upgrades without breaking.

Since ERP is moving to the cloud, quarterly updates are now becoming mandatory. If you have a heavily customized system, quarterly upgrades are going to be a nightmare for your teams. So, your new goals have to clear and concise, and I would propose the following:

  • Remove custom code from core. Keep it standard and simple.

  • Use SAP BTP or low-code for extensibility.

  • Guard your upgrade path from technical debt

I explained the structure and rationale in detail in article on the importance of a clean core strategy, including how clean core separates what should move fast from what must stay stable.

Still, most teams don’t plan their clean core until halfway into their transformation. That’s too late. You lose leverage in tool design and often end up with duplicated logic.

3. Ownership Problems No One Talks About

What we don’t talk about enough is this: ERP modernization introduces new governance gaps. The gap of who owns what! With a cloud landscape which is spread across multiple applications, ownership should be clear and specific. You need to answer questions like:

  • Who owns the APIs between Salesforce and ERP?

  • Who signs off on a workflow that spans SAP and ServiceNow?

  • Who resolves conflicting priorities when both systems need updates?

I’ve seen this delay go-lives by months. And sometimes, teams don’t even realize they’re stuck until integration testing reveals the overlap.

In one case, we had five systems touching the same supplier master. Five. No one had a master ownership document. That’s not a technical issue. It’s a governance issue.

4. Data: A Few Numbers That Matter

If you’re trying to size the overhead of a hybrid ERP model, here are some quick stats pulled from recent transformation reviews:

  • 70% of S/4HANA customers also run ServiceNow for workflows

  • 55% integrate Salesforce directly with their ERP layer

  • 35% say their biggest delay came from unclear data ownership, not technical blockers

These aren’t marginal numbers. They’re structural signals that ERP modernization needs architecture and governance before tooling.

5. Define What ERP Should Not Do

One of the best framing questions you can ask is, “What shouldn’t ERP be responsible for anymore?”

If you skip this, you’ll end up repeating the old sins, building heavy platforms that do too much, update too slowly, and frustrate everyone. That’s avoidable.

But it takes early decisions, honest debate, and clarity in scope. You might also find this breakdown on ServiceNow and SAP integration useful, especially if workflows are starting to sprawl.

Modernization is not about shiny tools. It’s about strategic subtraction.

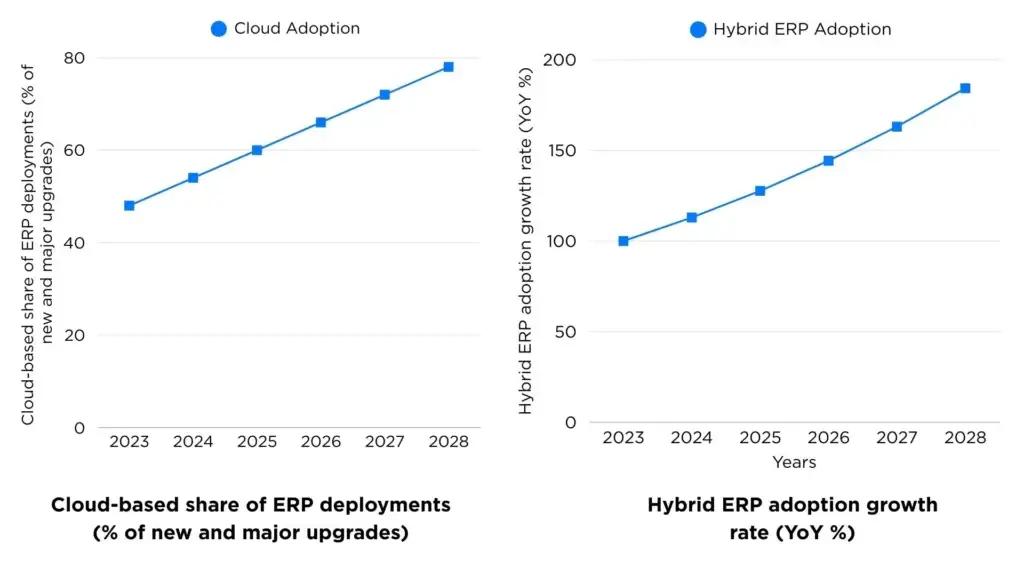

Public cloud spend, worldwide, USD billions

Sources

  • IDC. Worldwide Public Cloud Services Spending Will Reach 805.2 Billion in 2024. Press release, 24 July 2024.

  • IDC. Worldwide Public Cloud Services Spending Will Double by 2028. Press release, 10 December 2024.

  • Fierce Network. Gartner: Public cloud spending will jump 20% in 2024 on AI growth. News coverage, 13 November 2023. Fierce Network

  • CIO Dive. Global cloud spend to surpass 700B in 2025 as hybrid adoption spreads. News coverage, 19 November 2024. ciodive.com

ERP Modernization 2025 — Execution Signals, Benchmarks & 90-Day Actions

ERP Modernization 2025

Execution Signals, Benchmarks & 90-Day Actions

ECC → S/4 EBS → Fusion Clean Core FinOps for ERP Interoperability

What changed since 2024 and how to act in the next 90 days
Signal & why it matters (2025) Benchmarks & 90-day actions

Deadlines are forcing decisions

ECC support cliff is close enough to create staffing gaps; delay has turned technical debt into daily operational drag.

Benchmarks
  • SAP: ~35% of ECC customers started S/4 moves (mid-2025); many still in sandbox.
  • Oracle: ~40% of EBS exploring Fusion; <20% live.
  • Talent lead time: 4–9 months for S/4/Fusion specialists.
90-day actions
  • Lock approach (brownfield/greenfield/selective); freeze scope churn.
  • Reserve partner capacity and internal SMEs; publish skills ramp.
  • Set code-freeze and back-plan cutover (T-90/T-60/T-30).

Clean core is a discipline problem

Business units expecting legacy custom code to be re-built damage upgrade cadence and cause regressions.

Benchmarks
  • Core customization ratio ≤15%.
  • Critical regression breakage <3% after upgrades.
  • ≥70% of net-new asks delivered via extension platforms (BTP/OCI/OIC/low-code).
90-day actions
  • Form an Extension Review Board; define “core vs. extend.”
  • Retire top-25 Z-objects with owners and dates.
  • Automate regression for FI, OTC, P2P, MRP, WM/EWM.

Cloud ERP is shifting budgets

Spend moves from CAPEX to subscriptions/platforms; integration and monitoring overhead was underestimated.

Benchmarks
  • 2025 public cloud spend ≈ $679B (IDC) for CFO context.
  • CVI = (usage fees + integration run + add-ons) / ERP OPEX; red if >0.35.
  • Reduce inactive named users by ≥10% in a quarter.
90-day actions
  • Tag costs by module/integration; set guardrails and alerts.
  • Stand up a FinOps-for-ERP cadence with Finance/IT/Procurement.
  • Rationalize add-ons; enforce exit clauses.

Finance: controls and audit trail

ML touches AP/AR/risk; many audit teams still use 2019 templates, creating control gaps.

Benchmarks
  • Touchless AP ≥60% mid-maturity; ≥85% top quartile.
  • Each model decision logged with inputs, reason code; review SLA ≤1 business day.
  • Close-to-report variance ≤5% vs. baseline month post go-live.
90-day actions
  • Map model decisions to SOX/ITGC; add compensating controls.
  • Publish an audit pack generator (evidence, logs, approvals).
  • Lock vendor master governance; block free-text supplier creation.

Supply chain: partial modernization

Planning in IBP with execution in ECC/WM and Ariba/TM handoffs creates latency and errors.

Benchmarks
  • Plan→execute latency ≤15 min for inventory updates; red if >2 hrs.
  • GRN straight-through ≥80% with Ariba.
  • Backorder aging (90th pct) <7 days.
90-day actions
  • Adopt event-based updates between IBP/EWM/TM; remove spreadsheet handoffs.
  • Define canonical UoM/packaging; enforce at interfaces.
  • Launch an “inventory freshness” SLO dashboard for DCs/plants.

Regulatory exposure (pharma, aerospace, public sector)

Traceability and documentation must be provable on demand; ECC/EBS gaps become audit findings.

Benchmarks
  • Audit pack compiled within 5 business days without consultants.
  • Manual touchpoints per GxP process ≤2; e-sign/e-record compliant.
  • Supplier traceability coverage ≥95% of regulated SKUs.
90-day actions
  • Stand up an evidence store (logs, genealogy, approvals) with retention rules.
  • Run a mock audit on three high-risk processes; close gaps with dated owners.
  • Harmonize COA/MBOM/EBOM across ERP, PLM, QMS.

ERP is not the only platform

ServiceNow orchestrates processes, Salesforce drives customer work, Workday owns HR; ERP remains the financial backbone, so interoperability is key.

Benchmarks
  • Published event catalog; data contracts cover ≥80% cross-app events.
  • Idempotency/replay policies defined for all ERP-edge integrations.
  • MTTR for interfaces <4 hours; no manual rekeying.
90-day actions
  • Map system-of-record per master/object with named owners.
  • Introduce a shared event bus or webhook hub; standardize payloads/versioning.
  • Add layered governance: security, data, change reviews in one cadence.

Execution cadence

Workshops are done; cadence prevents sandbox stalls and keeps outcomes moving.

Benchmarks
  • Monthly release train; emergency fixes separate lane.
  • Regression cycle ≤10 days; automation ≥70% of pack.
  • Cutover rehearsal at T-30; Sev-1 open = 0 at T-7.
90-day actions
  • Single program board visible to the C-suite.
  • Two dry-runs: technical cutover and business continuity.
  • Define SLAs for data loads, interface catch-up, reconciliation.

Resourcing and ownership

Partner availability is tight; internal ownership sets pace and quality.

Benchmarks
  • Partner dependency ratio ≤0.6 by phase 3.
  • Named process owners for OTC, P2P, MTS/MTO, R2R with signed RACI.
  • SME backfill plan in place before SIT.
90-day actions
  • Secure core architect and test lead; lock SIT/UAT calendars.
  • Train-the-trainer; record golden-path demos per process.
  • Stand up a hypercare command center plan now.
Noel D'Costa

See How I Make Your ERP and AI System Selection or Implementation right for you.

ERP & AI System Selection – Identify and choose the right ERP or AI-enabled platform to fit your business needs.

Project Support & Recovery – Keep your project on track or bring failing implementations back under control.

ERP Modernization – Transform existing ERP systems to modern, efficient, and scalable ERP environments.

GET IN TOUCH

AI’s Role in ERP Modernization in 2025: Driving Decision Making

ERP Modernization in 2025

1.  Why AI finally matters inside the process

Therefore, AI now sits inside transactions and approvals, not as a bolt-on utility, which changes the daily rhythm of work. Moreover, embedded models act on structured data at posting time, so planners and controllers see options before problems harden.

However, value shows up only when architecture and operating model line up, which I learned the slow way on a regional rollout.

  • Consequently, teams design AI for the step where a human decides, not after the fact.

  • Additionally, leaders review model outcomes in business terms, not model metrics.

2.  Finance that explains itself

Consequently, finance leaders use automated reconciliations, anomaly detection, and predictive cash flow to shorten close and reduce surprises.

Moreover, shared narratives move into tools that business can read, and I prefer to surface stories through SAP Analytics Cloud, since adoption improves when insight travels with context.

  • Therefore, AI-driven finance flags outliers at sub-ledger level and proposes entries with supporting evidence.

  • Additionally, controllers run predictive cash positions during working capital huddles and adjust terms earlier.

  • Furthermore, audit teams trace AI suggestions to data lineage, which lowers rework at year end.

3.  Supply chain that anticipates exceptions

Accordingly, demand planning shifts toward demand sensing, exception management, and predictive logistics that trigger before planners open the dashboard.

Moreover, the planning cadence stabilizes when signals flow through an integrated design, which I outline in this primer on why SAP IBP matters.

  • Therefore, short-cycle signals update safety stock and transport plans during the week.

  • Additionally, exception queues route to the one role that can actually resolve the issue today.

  • Likewise, predictive ETA feeds customer promise dates without manual status chases.

4.  Clean core and clean data, or no AI

Accordingly, a clean core strategy becomes both a technical and business requirement, since quarterly releases and model retraining demand stable foundations.

Moreover, legacy customizations distort posting logic and break features, which I see almost every time in programs that skipped the hard refactoring.

Additionally, strong policies around model risk and access help you sustain trust, which is why I often anchor governance with these AI governance services.

  • Therefore, keep ERP as the transactional backbone and move intelligence to extensibility layers.

  • Furthermore, document feature toggles and versioning, since drift often hides there.

  • Moreover, retire bespoke integrations that your data scientists quietly route around.

5.  Operating model and cost reality

Consequently, AI readiness typically lifts ERP program budgets by 12 to 15%, and the uplift lands in data engineering, testing, and skills. Moreover, integration choices matter because CRM and service workflows drive a large share of events, and failed handoffs are common, which I unpack in this note on why ERP integration with Salesforce fails.

  • Therefore, 72% of CFOs expect AI-enabled anomaly detection in finance by 2026, so training and change plans need to move now.

  • Additionally, 65% of supply chain leaders use AI for planning in pilots, while about 30% run production today.

  • Likewise, teams that ignore integration hygiene repeat the mistakes described in these modernization pitfalls.

What to do next, practically

Accordingly, scope a small set of AI-ready processes inside your ERP Modernization in 2025 program and measure decision latency, not dashboard clicks. Moreover, tie each use case to a data contract and a single business owner, which sounds basic, yet it holds the gains after go-live.

ERP Modernization Strategy

Cloud-First Economics: Cost Focus in the Key

ERP Modernization in 2025

Cloud ERP growth sets the tone for ERP Modernization in 2025, and boards feel the pace. The spend for Cloud ERP is projected to cross $679 billion in 2025, and that number could change depending on how every CFO frames risk and timing.

1.  Why costs are shifting?

CFOs continue to move from CAPEX to OPEX for cleaner cash flow and fewer surprise spikes. Rather than spend millions of dollars on licenses in the form of CAPEX, CFOs would rather positively impact their cash flow by moving to OPEX and switch off subscriptions when they don’t need it.

Quarterly update cadence also spreads effort, which smooths budgets yet exposes hidden run costs. So what does this mean for companies?

  • Predictable OPEX makes funding easier to defend during audit readiness reviews.

  • Capacity planning moves from purchase orders to usage forecasts.

  • Contracts favor shorter terms that can flex with demand.

2.  What TCO really includes now?

TCO is no longer about licenses. It is about the people and process required to keep changes safe and compliant.

  • License cost sits under 25% of ERP budgets, as I detail in this cost breakdown. I have outlined in this article how costs are broken down based on industry and cost categories.

  • Regression testing, downtime, and compliance account for 40 to 45% of TCO, which is why I push tool choice early in design using these change and test tools and this test tooling comparison.

  • Cloud operational costs are rising about 18% year on year through 2027, so teams must track autoscaling, monitoring, and data egress with real metrics. Yes, there are tools to track consumption and how does that consumption related to a dollar value.

3.  How the quarterly update cadence changes budgets?

Quarterly releases demand continuous readiness and faster decision cycles. The result feels lighter, although the planning discipline must rise. So, instead of executing on monolithic upgrades, it definitely feels lighter to work on quarterly updates, which are more manageable. So what does this mean?

  • Release rehearsal becomes a monthly habit, reinforced with quality gates.

  • Cutover windows shrink, while rollback paths need rehearsal.

  • Program controls tighten around scope and capacity, which I map in this guide to planning and control.

4.  Practical levers CFOs can pull

I have sat in those budget reviews, and I still cringe when teams miss simple levers. Small moves add up. So the focus should be on these elements:

  • Tie funding to verified increments, and avoid year-long big bangs, as warned in ERP modernization pitfalls.

  • Model OPEX with your own telemetry and compare options using the ERP cost calculator.

  • Shift non-critical testing to off-peak windows to reduce egress and environment burn.

  • Embed audit readiness into every release note and control checklist, rather than waiting for quarter end.

I think the quiet cost is attention. Because teams split focus across security, compliance, and delivery, leaders must keep one rule clear. Spend where it removes risk quickly and let the quarterly cadence compound that benefit.

Cloud-First Economics: Cost Focus Is the Key — ERP Modernization 2025

Cloud-First Economics

Cost Focus Is the Key

Cloud ERP growth ~$679B in 2025 OPEX shift TCO clarity Quarterly cadence CFO levers

Cloud ERP sets the tone in 2025; boards feel the pace. Spend may cross ≈$679B, shaped by how CFOs frame risk and timing.
Signal & why it matters (2025) Benchmarks & 90-day actions

Why costs are shifting

CFOs prefer OPEX for smoother cash flow and the option to switch off subscriptions. Quarterly updates spread effort but surface hidden run costs.

Benchmarks (targets)
  • OPEX share of ERP spend ≥65% (review outliers monthly).
  • Contract Flex Ratio (CFR) = seats on ≤12-month terms / total seats ≥0.50.
  • Usage Forecast Accuracy (60-day) ≥85% for core environments.
90-day actions
  • Tag all costs by module/env; add guardrails for autoscaling and idle hours.
  • Shift capacity planning from POs to rolling 90-day usage forecasts.
  • Publish a Stop-Start Playbook to pause non-critical subscriptions each quarter.

What TCO really includes now

People and process drive TCO—keeping changes safe and compliant—not just licenses.

Benchmarks (use as targets)
  • Licenses ≤25% of ERP budget.
  • Regression + downtime + compliance = 40–45% of TCO; track as separate lines.
  • Cloud ops run-rate trending ~18% YoY through 2027; set quarterly caps.
  • Change Safety Cost (CSC) = (testing + controls + audit prep) / TCO ≤30% by Q4.
90-day actions
  • Select change/test tooling in design; define a critical regression pack now.
  • Set SLOs for planned downtime per quarter and evidence-pack completeness.
  • Instrument autoscaling, monitoring, and data egress with unit costs (per GB/hour).

How the quarterly cadence changes budgets

Smaller, frequent releases shift budgets to continuous readiness; planning discipline must rise.

Benchmarks (targets)
  • Monthly release rehearsal on time ≥95%.
  • Change failure rate <10%; rollback time ≤30 minutes.
  • Update Readiness Index (tests ready, owners booked, comms signed) ≥90% by T-7.
90-day actions
  • Book fixed rehearsal slots; enforce quality gates pre-deploy.
  • Shrink cutover windows; practice rollback twice per quarter.
  • Tighten controls on scope and capacity; publish one program control board.

Practical levers CFOs can pull

Small moves add up. Spend where it removes risk quickly and let the quarterly cadence compound the benefit.

Benchmarks (targets)
  • Verified-Increment Funding ≥70% of run initiatives.
  • Idle license rate <5%; inactive env hours <8% of total.
  • Off-peak test hours ≥50% of non-prod execution to cut egress/env burn.
  • Release notes with audit artifacts coverage = 100%.
90-day actions
  • Tie funding to shipped increments; avoid year-long big-bang allocations.
  • Model OPEX with your telemetry; compare options using an ERP cost calculator.
  • Schedule non-critical testing in off-peak windows; right-size environments.
  • Embed audit readiness into every release checklist; no quarter-end scrambles.

ServiceNow and Parallel Platforms Driving Simplicity in ERP Workflows

ServiceNow-Leverages-Partnerships-to-Meet-Customers-Where-They-Are

Today, ERP Modernization in 2025 favors a simple backbone and smarter satellites, and I admit the shift feels overdue. Consequently, enterprises now treat ERP as the stable ledger while the ERP ecosystem handles the experience and velocity.

Why parallel platforms fill the gaps

Now, ERP no longer covers every process with grace, and that is fine. Therefore, platforms like ServiceNow, Salesforce CRM, and SAP IBP fill specific gaps with lighter configuration and faster iteration. For example, I outline why this pairing works in my note on SAP and ServiceNow together.

  • Moreover, SAP keeps the journal entries correct while ServiceNow handles approvals, knowledge, and case routing.

  • Additionally, clean core decisions stay intact because extensions live outside the transactional tier.

Workflows shift into ServiceNow

Today, HR, IT, and customer service workflows move out of ERP because teams want clear SLAs and self-service portals.

Consequently, ServiceNow integration reduces custom code inside the core and improves audit trails. As a reference, I share practical handoffs in the same ServiceNow guide.

  • Furthermore, about 70% of enterprises use ServiceNow for IT and HR workflows, and teams often start with incident and request flows.

  • Likewise, governance and catalog design matter early, so intake rules prevent noisy work queues.

CRM and planning outside the core

Similarly, Salesforce often leads customer engagement while ERP plays the backbone role. Consequently, you should expect data ownership debates, and you should plan them, because I have watched timelines slip when this part stays vague, as covered in Salesforce integration pitfalls

Meanwhile, SAP IBP planning lives near demand signals, as I explain in my view on why SAP IBP matters.

  • Therefore, CRM drives pipeline truth while ERP validates orders and credit.

  • Additionally, IBP planning aligns supply scenarios with finance through repeatable S&OP cycles.

Integration and governance complexity

However, as ecosystems expand, governance complexity grows, and the hidden cost rises. Consequently, I recommend a shared control model with data stewards, API versioning, and release quality gates, which I outline in my notes on AI governance in SAP programs.

  • Moreover, governance and integration costs typically reach 15 to 20% of ERP modernization budgets.

  • Likewise, cost risk improves when teams budget for hands-on testing and platform owners, which I unpack in this budget breakdown.

Design ERP as a platform strategy

Finally, enterprises should design modernization as a platform strategy rather than a single product upgrade.

Consequently, an integration platform and a clean core stance simplify change, as summarized in my guide to SAP integration platforms and this take on the clean core strategy.

  • Therefore, publish decision rights for data domains and user experience early, even if the list feels rough.

  • Additionally, keep metrics visible, because teams move faster when adoption, cycle time, and failure counts sit on one dashboard.

ServiceNow & Parallel Platforms Driving Simplicity in ERP Workflows — 2025

Parallel Platforms

ServiceNow & Co. Driving Simplicity in ERP Workflows

Clean core ServiceNow Salesforce SAP IBP Interoperability Governance

ERP stays the ledger; satellites carry the experience and pace. Keep extensions out of the transactional tier.
Signal & why it matters (2025) Benchmarks & 90-day actions

Why parallel platforms fill the gaps

ERP doesn’t cover every process well. ServiceNow, Salesforce, and SAP IBP handle approvals, cases, customer work, and planning with faster iteration. Journal entries stay correct in ERP; extensions live outside the core.

Benchmarks (targets)
  • Workflow Offload Ratio (WOR) = workflows in satellite platforms / total cross-functional workflows ≥0.50.
  • Core Customization Ratio ≤15% (keep Z-code and mods down).
  • Event-based integrations cover ≥80% of cross-app handoffs.
90-day actions
  • Define “must-be-core vs. extend” rules; route approvals/cases to ServiceNow.
  • Stand up an event catalog and payloads for order, credit, GRN, shipment.
  • Move knowledge, request, and case routing out of ERP to cut custom code.

Workflows shift into ServiceNow

HR, IT, and customer service want clear SLAs and self-service. ServiceNow reduces core custom code and improves evidence trails. ~70% of enterprises already use it for IT/HR flows.

Benchmarks (targets)
  • Approval Evidence Coverage (AEC) = approvals with attached proof / total approvals = 100%.
  • Catalog Signal-to-Noise (CSN) = actionable requests / total requests ≥0.85.
  • Mean time to route (MTR) from intake to owner ≤15 minutes for priority items.
90-day actions
  • Publish intake rules and a lean catalog; block free-text where possible.
  • Map ERP↔ServiceNow handoffs (incidents, requests, change) with owners and SLAs.
  • Enable audit-ready logs: approver, reason, attachments, and retention policy.

CRM and planning outside the core

Salesforce leads customer engagement; ERP validates orders and credit. SAP IBP sits near demand signals and aligns scenarios with finance through repeatable S&OP.

Benchmarks (targets)
  • Lead→order sync ≤15 minutes; order validation cycle ≤5 minutes.
  • S&OP cadence monthly; scenario turn-around ≤48 hours with finance sign-off.
  • Data ownership RACI published for Account, Product, Price, Credit, Forecast.
90-day actions
  • Pin API versions; standardize payloads for quotes, orders, and credit checks.
  • Define “system of record” per object; document conflict-resolution rules.
  • Connect IBP to finance drivers; store scenario assumptions with version IDs.

Integration and governance complexity

More platforms increase governance needs. Hidden cost rises without data stewards, API versioning, and quality gates. Governance and integration often run 15–20% of modernization budgets.

Benchmarks (targets)
  • Governance + integration spend 15–20% of total; cap at 18% where possible.
  • Event Contract Coverage (EvCC) ≥80%; Interface MTTR <4 hours.
  • Change failure rate for interfaces <10%; rollback tested every quarter.
90-day actions
  • Appoint data stewards per domain; enforce API version lifecycles and deprecation.
  • Introduce release quality gates: schema checks, contract tests, and evidence packs.
  • Fund platform owner roles; mandate hands-on testing before each release.

Design ERP as a platform strategy

Treat modernization as a platform move, not a product swap. Clean core plus an integration platform makes change safer and faster to run.

Benchmarks (targets)
  • Decision rights published for data and UX; coverage ≥90% of major objects.
  • Dashboard shows adoption, cycle time, and failure counts in one view.
  • Core customization ratio trending down quarter over quarter.
90-day actions
  • Stand up an integration platform (event bus or gateway) with versioned contracts.
  • Lock a clean-core stance; push extensions to BTP/ServiceNow/CRM/IBP, not ERP.
  • Publish the platform scorecard: adoption, latency, MTTR, change failure rate.

Key Pressures and Risks in 2025 Facing ERP Modernization

Bias & Fairness Risks

Firstly, ERP Modernization in 2025 faces real time pressure that leaders can feel in weekly steering calls. Secondly, I think the trick is to treat risk as design input rather than as a cleanup task at the end.

1.  The clock on SAP ECC and Oracle EBS

Firstly, the SAP ECC 2033 deadline with optional extensions shapes every roadmap discussion I join. Secondly, the move to S/4 is not a lift and shift, as I outline in this practical guide on the ECC to S/4HANA migration.

  • Moreover, Oracle EBS migrations to Fusion behave like reimplementations rather than upgrades.

  • Additionally, platform choices deserve a side-by-side look, and this comparison on Oracle ERP vs SAP helps frame cost, scope, and timing.

2.  Reimplementation risk and system integrator capacity

Secondly, most portfolios face a labor bottleneck because skilled system integrators remain fully booked. Secondly, capacity limits push rates higher and stretch testing windows, which I describe in this view on SAP implementation cost and budget breakdown.

  • Moreover, average ECC landscapes carry parallel rollouts that compete for the same architects.

  • Additionally, programs slip when teams defer decision rights and environment plans, which I address in project planning and control.

3.  Custom code cleanup and audit exposure

In the third instance, the typical SAP ECC system carries 1,500 to 3,000 custom objects based on assessments I have run across manufacturing and services. Usage scans show only about 25% see active business usage, and the remainder inflates migration cost and risk.

  • Moreover, audit flags tied to custom code grow about 15 percent year over year because change traces lack owners.

  • Additionally, clean core discipline reduces this load, and I share a stepwise approach in the clean core strategy guide.

4.  Quarterly release disruption

Fourthly, quarterly release cycles look fine on a slide, yet they collide with finance closes and seasonal supply chain peaks. Secondly, regression testing, downtime coordination, and compliance evidence now dominate total cost of ownership.

  • Moreover, teams avoid noise by enforcing quality gates and by automating fit-to-standard tests, as compared in the testing and validation tools review.

  • Additionally, leaders budget explicit time for release cutovers, because silent squeezes on month-end always surface later.

5.  Data migration and rework risk

Data debt multiplies schedule risk when harmonization starts late. Secondly, I explain recurring traps in this note on why SAP data migration fails.

  • Moreover, duplicate vendors, unit conversions, and pricing conditions generate noisy defects that teams mislabel as “system bugs.”

  • Additionally, IBAN, tax, and compliance checks require early proofs to satisfy audit readiness during go-live rehearsals.

6.  Practical moves for the next 90 days

Finally, sponsors should publish a cut list for custom objects and remove low-value code before design finalization. Secondly, programs should anchor risks to costed mitigations, and this checklist on risk assessment and mitigation helps.

  • Moreover, architects should define quarterly release windows that avoid close periods and peak shipping weeks.

  • Additionally, PMOs should track active usage, integration counts, and test coverage on one dashboard to keep reimplementation risk visible.

So in summary, the pressures are real and slightly messy, and that is fine. If leaders treat deadlines, custom code cleanup, quarterly release disruption, and capacity limits as first-class design inputs, the modernization story holds together.

Key Pressures & Risks in 2025 — ERP Modernization

Pressures & Risks — 2025

ERP Modernization: What Bites, What to Do

ECC 2033 EBS → Fusion SI capacity Custom code Quarterly releases Data migration

Time pressure is real. Treat risk as design input, not cleanup.
Signal & why it matters (2025) Benchmarks & 90-day actions

The clock on SAP ECC and Oracle EBS

ECC 2033 (with paid extensions) and EBS→Fusion moves shape every roadmap. These are reimplementations, not lifts-and-shifts.

Benchmarks
  • Approach locked (brownfield/greenfield/selective) by week 6.
  • Platform comparison complete (SAP vs Oracle) by week 4 with cost/scope/timing deltas.
  • Resource lead time: 4–9 months for key roles (architect, test lead).
90-day actions
  • Run fit-to-standard and side-by-side eval; decide stack and scope.
  • Issue partner RFPs; pre-book migration waves and cutover windows.
  • Publish decision rights (who signs approach, scope, dates).

Reimplementation risk & SI capacity

Skilled integrators are booked; rates rise; testing windows shrink. Parallel rollouts compete for the same architects.

Benchmarks
  • Environment plan published (DEV/SIT/UAT/PROD) with freeze dates.
  • Partner dependency ratio ≤0.6 by SIT start.
  • Decision latency <5 business days for level-1 scope items.
90-day actions
  • Lock environment calendar; reserve test data and interfaces.
  • Stand up a single risk log with costed mitigations and owners.
  • Backfill SMEs; stop over-committing shared architects.

Custom code cleanup & audit exposure

Typical ECC carries 1,500–3,000 custom objects; ~25% show active use. The rest bloats cost and risk. Audit flags on custom code grow ~15% YoY.

Benchmarks
  • Cut list reduces Z-objects by ≥30% pre-design freeze.
  • Owner assigned for every retained object; change logs complete.
  • Core customization ratio ≤15% at build start.
90-day actions
  • Run usage scans; deprecate idle code; plan retirements in two sprints.
  • Move extensions to platforms (BTP/ServiceNow) to protect clean core.
  • Enable audit evidence packs for custom flows (approvals, test proofs).

Quarterly release disruption

Releases collide with close and peak seasons. Testing, downtime, and evidence now dominate TCO.

Benchmarks
  • Update Readiness Index ≥90% by T-7.
  • Planned downtime ≤6 hours/quarter per system.
  • Change failure rate <10%; rollback proven ≤30 minutes.
90-day actions
  • Fix release windows away from close and peak weeks.
  • Automate fit-to-standard tests; enforce quality gates.
  • Budget explicit cutover effort; stop “silent squeezes” at month-end.

Data migration & rework risk

Late harmonization drives defects (duplicate vendors, UoM, pricing). IBAN/tax checks need early proofs to pass audit during rehearsals.

Benchmarks
  • Master data completeness ≥98% by SIT1; critical fields 100%.
  • UoM/price conversion defects <2% in SIT1; zero Sev-1 by UAT start.
  • IBAN/tax validations ≥99% pass in dry runs.
90-day actions
  • Publish canonical maps (vendor, product, UoM, pricing).
  • Run two load rehearsals with reconciliation and defect triage.
  • Assign data stewards and sign off ownership per domain.

Make risk a design input

Deadlines, capacity, custom code, cadence, and data only improve when built into design—early.

Benchmarks
  • Risk→Mitigation map approved with budget lines.
  • Dashboard live: active usage, interface count, test coverage.
  • Release calendar, decision rights, and cut list published.
90-day actions
  • Publish and execute the custom-object cut list.
  • Fund mitigations now (not post-go-live): testing, monitoring, rollback.
  • Keep one program board visible to sponsors weekly.

Expert Guidance for ERP Modernization in 2025

ERP Modernization in 2025

Firstly, ERP Modernization in 2025 works best when leaders treat the program as a business redesign with clear boundaries. Secondly, I have learned that small, steady governance choices beat big-bang heroics every time.

1.  Treat ERP as a backbone

In my opinion, you should treat ERP as the transactional backbone that feeds reliable data to the rest of the enterprise. Secondly, you can shape upstream and downstream flows with an ecosystem design rather than force every workflow into the core.

2.  Make clean core non-negotiable

Clean core lowers change friction and raises audit confidence, and it also unlocks AI readiness and quarterly updates. Secondly, I outline a pragmatic approach in the clean core strategy guide.

  • Moreover, clean core adoption typically cuts regression testing effort by 20 to 30 percent, and teams feel that in every release.

  • Additionally, strict extensions via stable APIs protect your ERP backbone from customization creep.

3.  Budget for operational TCO

I also recommend you should budget for operational TCO rather than just software, because testing, downtime, and compliance now shape run costs. Secondly, this breakdown of SAP implementation cost and budget pairs well with my comparison of testing and validation tools.

  • Moreover, I advise CFOs to reserve a release contingency that scales with interface count and user concurrency.

  • Additionally, PMOs should publish a quarterly update cadence that avoids close periods.

4.  Design the ecosystem and roadmap

Your ERP roadmap should center on the ecosystem and not a single platform, because ServiceNow and Salesforce will keep leading key workflows. Secondly, you can reduce rework by addressing CRM touchpoints early, and this field note on Salesforce integration pitfalls explains why.

  • Moreover, ecosystem-led roadmaps lower integration issues by about 15 percent when teams align data contracts up front.

  • Additionally, I prefer a two-speed plan that lands core finance first and layers IBP planning next.

5.  Govern the edges with intent

Finally, integration sprawl grows fast, so you should standardize on patterns and platforms from day one, and this page on SAP integration platforms helps frame the options.

Secondly, light but firm governance keeps operational TCO predictable and keeps audits calm.

Actionable checklist

  • Firstly, define what the ERP must do and what it will never do, and publish the boundary.

  • Secondly, adopt clean core rules and measure compliance in design reviews.

  • Moreover, fund automated testing to keep quarterly releases safe and boring.

  • Additionally, lock a data contract for Salesforce and ServiceNow before build starts.

  • Finally, stage value by roadmap waves that respect peak periods and capacity.

Firstly, the advice sounds simple and perhaps a bit strict, and that is intentional. Secondly, if you treat ERP as a backbone, invest in clean core, plan for operational TCO, and govern the ecosystem with care, the modernization program stays resilient even when real life gets untidy.

ERP Modernization Planning & Execution

Conclusion: The Future of ERP Modernization: 2025-2028 will be Important

So, ERP Modernization in 2025 comes down to cloud-first ERP, steady AI integration, and a modular ecosystem that treats ERP as the backbone.

Moreover, teams that pair clean core discipline with a clear delivery rhythm move faster and break less, and a practical playbook for structure sits in this guide on quality gates.

Consequently, legacy stacks like SAP ECC and Oracle EBS feel fragile as support windows narrow, and leaders face tough timing calls. Additionally, program owners can frame migration choices with this focused view of S/4HANA implementation, and they can plan capacity before the window gets tight.

Meanwhile, platform work spreads across ServiceNow and specialized SaaS, and governance becomes the real limiter more often than code.

Furthermore, steering groups that follow a firm stakeholder management strategy reduce noise during quarterly updates and protect audit readiness when small changes stack up.

Accordingly, boards expect proof that TCO is managed as an operational number, not a licensing line, and they want fewer surprises in month twelve.

Moreover, finance leads can pressure test cash and effort with this clear cost and budget breakdown, and I think a short pre-read like that changes the tone of approval meetings.

Therefore, the winners will balance urgency with disciplined architecture while they accept some ambiguity in the path.

Finally, by 2033 most SAP ECC customers must complete migration, and ecosystem programs already grow roughly two times faster than monolithic rollouts, which tracks with what I keep seeing on the ground.

If you have any questions or want to discuss your concerns on SAP Performance Testing, please don't hesitate to reach out!

FAQs on ERP Modernization in 2025

The ECC 2033 horizon and the Oracle Fusion reimplementation effort create a real countdown that boards feel in weekly reviews.

Partner capacity and internal SME time stay tight, which means dithering turns into cost and schedule pain.

Moreover, you can learn the early traps in my guide on ERP modernization mistakes and you can pressure test partner choices with the list of top SAP implementation partners in the USA.

Quick tells I watch:

  • Therefore, decisions on approach slip past week six.
  • Additionally, architects split across two programs.
  • Moreover, risk logs exist, yet mitigations have no owners.

I run three tests before I touch tools, which are custom code reliance, master data health, and tolerance for process change.

Additionally, if more than thirty percent of business critical flows rely on Z objects, I lean selective or greenfield, although I still confirm data quality first.

Moreover, you can compare paths in the guide on S4HANA migration strategy and you can see practical steps in the walkthrough on ECC to S4HANA migration.

What I do in practice:

  • I publish a cut list for top custom objects with owners.
  • I grade data domains A to C with clear steward names.
  • I timebox the decision to ten working days.

Licenses sit smaller while testing, compliance, monitoring, and downtime rehearsals drive most spend.

Run rates climb when teams ignore autoscaling, data egress, and environment idle hours, which I still see on many programs.

Moreover, you can model choices with the SAP implementation cost calculator and you can review drivers in the cost and budget breakdown.

Fast budget hygiene:

  • Tag every euro by module and environment.
  • Cap quarterly planned downtime and track change failure rate.
  • Fund only increments that ship.

I set a core customization ratio at or below fifteen percent by build start, and I move extensions to BTP, ServiceNow, or CRM.

Additionally, I audit that ratio monthly and I retire two small Z items every sprint, which sounds simple, yet it works.

Moreover, you can align thinking in the clean core strategy and you can choose controls with technical change tools for 2025 and the testing and validation comparison.

Signals that you are drifting

  • Regression failures rise after each hotfix.
  • Interface mappings fork per plant.
  • Upgrade windows keep growing.

I freeze canonical maps for vendor, product, units, and pricing before SIT, and I run two full rehearsals with reconciliation and owner sign off.

I also run IBAN and tax validations in every cycle, because finance close will expose any weak checks, and it always does.

Moreover, you can avoid the common traps in why SAP data migration fails and you can size loads with the free data migration estimator.

Data hygiene checklist:

  • Therefore, lock code lists and unit conversions by T minus thirty days.
  • Additionally, publish a defect taxonomy that separates data errors from system bugs.
  • Moreover, appoint stewards per domain with real names on the page.

I keep ERP as the ledger and I move approvals, knowledge, and case routing to ServiceNow to cut custom code inside the core.

I also place customer engagement in Salesforce and I keep planning near demand signals in SAP IBP, and I wire the handoffs with stable event payloads.

Moreover, you can see the pattern in ERP with SAP and ServiceNow, and you can fix brittle CRM patterns using Salesforce integration pitfalls while you anchor the backbone on SAP integration platforms.

Practical handoffs I use:

  • Therefore, quotes, orders, credit checks, goods receipt, and shipment events stay versioned.
  • Additionally, idempotency rules and replay policies sit in one page.
  • Moreover, I test latency under peak, not only correctness.

Smaller releases still need discipline, which means monthly rehearsals, a stable regression pack, and quality gates that block risky changes early.

Rollback must run in under thirty minutes and evidence must attach to release notes, or audits will drag people away from delivery.

Moreover, you can compare validation tools in the testing and validation comparison, you can protect timelines with project planning and control, and you can formalize checkpoints with SAP quality gates.

Cutover habits that save weekends:

  • Schedule windows away from close and peak shipping weeks.
  • Additionally, record golden path demos for each role to speed triage.
  • Moreover, rehearse rollback twice per quarter.

I test end to end business flows under realistic peaks, which include finance close, warehouse waves, and promotion spikes. Additionally, I track plan to execute latency across systems, because cross app lag creates wrong inventory and wrong cash timing even when screens feel fast.

You can also design useful load patterns in the guide on SAP performance testing and you can layer quick diagnostics with SAP Analytics Cloud.

Signals that really matter

  • Order to post time under peak should hold within five percent of baseline.
  • Additionally, warehouse confirmations must not fall during carrier cutoffs.
  • Moreover, interface MTTR should stay under four hours.

I treat risks as design inputs and I attach evidence to each release item so the audit trail is available on demand. Additionally, I align SOX and ITGC checkpoints with any AI assisted decision to avoid last minute scrambles, although I admit I still over document sometimes.

You can start with the risk assessment and mitigation matrix, and you can extend controls with AI governance in SAP implementations, and you can tune stricter rules with public sector compliance.

Evidence I ask to see

  • Model inputs, reviewer names, and reason codes sit with the ticket.
  • Additionally, retention rules match the regulation in scope.
  • Moreover, control failures trigger a small postmortem, not a blame round.

I track cost per change, touchless AP rate, plan to execute latency, interface MTTR, and automation coverage per release, and I report them on one page.

I also add backlog age for defects and training watch time for role videos, which sound small, yet they predict how steady next quarter will be.

Also you can lift clear formulas in ERP implementation KPIs, and you can cross check with the finance process modernization case study, and you can share status using tools in SAP project tracking tools 2025.

Simple KPI targets I recommend:

  • Therefore, change failure rate below ten percent and rollback under thirty minutes.
  • Additionally, automation covers seventy percent of the regression pack.
  • Moreover, plan to execute latency stays under fifteen minutes.

Editorial Process:

We focus on delivering accurate and practical content. Each article is thoroughly researched, written by me directly, and reviewed for accuracy and clarity. We also update our content regularly to keep it relevant and valuable.

Noel DCosta SAP Implementation

Stuck somewhere on your SAP path?

I’m Noel Benjamin D’Costa. I work with teams who want less confusion and want more clarity. If you’re serious about making progress, maybe we should talk.

This Article Covers:
Noel DCosta SAP Implementation Consultant

Noel Benjamin D'Costa

Noel D’Costa is an experienced ERP consultant with over two decades of expertise in leading complex ERP implementations across industries like public sector, manufacturing, defense, and aviation.

Drawing from his deep technical and business knowledge, Noel shares insights to help companies streamline their operations and avoid common pitfalls in large-scale projects.

Passionate about helping others succeed, Noel uses his blog to provide practical advice to consultants and businesses alike.

Noel DCosta

Hi, I’m Noel. I’ve spent over two decades navigating complex SAP implementations across industries like public sector, defense, and aviation. Over the years, I’ve built a successful career helping companies streamline their operations through ERP systems. Today, I use that experience to guide consultants and businesses, ensuring they avoid the common mistakes I encountered along the way. Whether it’s tackling multi-million dollar projects or getting a new system up and running smoothly, I’m here to share what I’ve learned and help others on their journey to success.

Leave a Reply

Your email address will not be published. Required fields are marked *

noel dcosta sap implementation

This website is operated and maintained by Quantinoid LLC

Your ERP & AI Transformation Starts Here

We use cookies to help improve, promote and protect our services. By continuing to use this site, you agree to our privacy policy and terms of use.

Let’s Talk SAP – No Sales, Just Solutions

Not sure where to start with SAP? Stuck in the middle of an implementation? Let’s chat. In 30 minutes, we’ll go over your challenges, answer your questions, and figure out the next steps—no pressure.

Subscribe for 30 minutes call
